EVM Measurement of 5G NR PUSCH Waveforms
R2026bThis example shows how to measure the error vector magnitude (EVM) of PUSCH fixed reference channel (FRC) waveforms. The example also shows how to add RF impairments, including in-phase and quadrature (I/Q) imbalance, phase noise and memoryless nonlinearity.
Introduction
For base station receiver RF testing, the 3GPP 5G NR standard defines a set of FRC waveforms. The FRCs for frequency range 1 (FR1) and frequency range 2 (FR2) are defined in TS 38.104, Annex A.

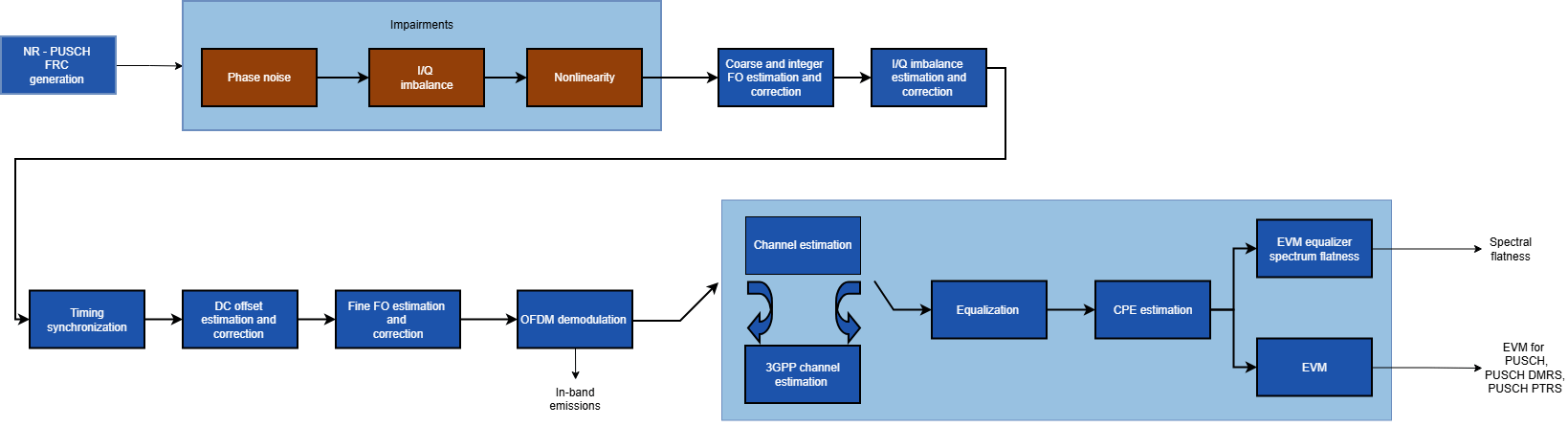

This example shows how to generate an NR waveform (FRC) and add impairments. The example uses in-phase and quadrature (I/Q) imbalance, phase noise and memoryless nonlinearities. It shows how to calculate the EVM of the resulting signal, and then plot the root mean square (RMS) and peak EVMs per orthogonal frequency division multiplexing (OFDM) symbol, slot, and subcarrier. Then calculate the overall EVM (RMS EVM averaged over the complete waveform). Annex F of TS 38.101-1 and TS 38.101-2 define an alternative method for computing the EVM in FR1 and FR2, respectively. The figure below shows the processing chain implemented in this example.

Simulation Parameters
Select one of the FRCs for FR1 and FR2.
rc ="G-FR1-A1-7"; % FRC % Possible overrides to Annex A definitions (empty values provide the Annex A defaults) bw = []; % Bandwidth override (5,10,15,20,25,30,40,50,60,70,80,90,100,200,400,800,1600,2000 MHz) scs = []; % Subcarrier spacing override (15,30,60,120,480,960 kHz) dm = []; % Duplexing mode override ("FDD","TDD") ncellid = []; % Cell identity override (used to control scrambling identities)
To print EVM statistics, set displayEVM to true. To disable the prints, set displayEVM to false. To plot EVM statistics, set plotEVM to true. To disable the plots, set plotEVM to false.
displayEVM =true; plotEVM =
true; if displayEVM fprintf('Reference Channel = %s\n',rc); end
Reference Channel = G-FR1-A1-7
To measure EVM as defined in TS 38.101-1 (FR1) or TS 38.101-2 (FR2), Annex F respectively, set evm3GPP to true. evm3GPP is disabled by default.
evm3GPP =
false;To generate the waveform, create a waveform generator object. To change the configuration parameters, make them writable using the makeConfigWritable function.
wavegen = hNRReferenceWaveformGenerator(rc,bw,scs,dm,ncellid); [txWaveform,tmwaveinfo,resourcesinfo] = generateWaveform(wavegen,wavegen.Config.NumSubframes);
Impairment: In-Phase and Quadrature (I/Q) Imbalance, Phase Noise and Memoryless Nonlinearity
This example considers the most typical impairments that distort the waveform when passing through an RF transmitter or receiver: phase noise, I/Q imbalance, and memoryless nonlinearity. Enable or disable impairments by toggling the flags phaseNoiseOn, IQImbalanceON, and nonLinearityModelOn.
phaseNoiseOn =true; IQImbalanceON =
true; nonLinearityModelOn =
true;
Normalize the waveform to fit the dynamic range of the nonlinearity.
txWaveform = txWaveform/max(abs(txWaveform),[],'all');The waveform consists of one frame for frequency division duplexing (FDD) and two for time division duplexing (TDD). Repeat the signal twice. For this example, remove the first half of the resulting waveform to avoid the transient introduced by the phase noise model.
txWaveform = repmat(txWaveform,2,1);
Introduce phase noise distortion. The figure shows the phase noise characteristic. The carrier frequency considered depends on the frequency range. We use values of 4 GHz and 28 GHz for FR1 and FR2, respectively. The phase noise characteristic is generated with the multipole zero model described in TR 38.803 Section 6.1.10. Set the MinFrequencyOffset property to a smaller value to improve the match between the realized and recommended power spectral density (PSD), with a trade-off of increased simulation time.

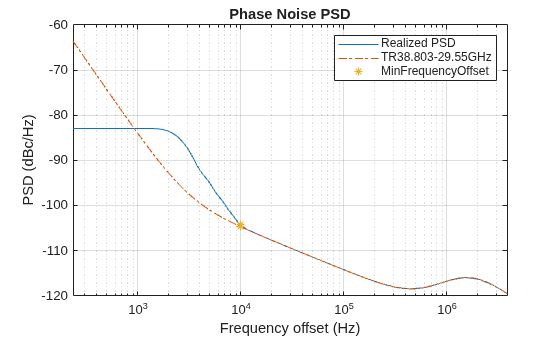

if phaseNoiseOn sr = tmwaveinfo.Info.SamplingRate; % Carrier frequency if wavegen.Config.FrequencyRange == "FR1" % Carrier frequency for FR1 fc = 4e9; else % Carrier frequency for FR2 fc = 28e9; end % Model phase noise pnoise = nrPhaseNoise(CarrierFrequency=fc, ... SampleRate=sr, ... MinFrequencyOffset=1e4,... RandomStream="mt19937ar"); % dBc/Hz, PoleZeroModel='TR38.803-auto' % Visualize spectrum mask of phase noise visualize(pnoise) % Apply phase noise to the waveform rxWaveform = pnoise(txWaveform); release(pnoise) else rxWaveform = txWaveform; %#ok<UNRCH> end

Introduce I/Q imbalance. Apply a 0.2 dB amplitude imbalance and a 0.5 degree phase imbalance to the waveform. You can also increase the amplitude and phase imbalances by setting amplitudeImbalance and phaseImbalance to higher values.
if IQImbalanceON amplitudeImbalance = 0.2; phaseImbalance = 0.5; rxWaveform = iqimbal(rxWaveform,amplitudeImbalance,phaseImbalance); end
To introduce nonlinear distortion, use the modified Rapp model in this example. Set the parameters for the Modified Rapp model to match the characteristics of the memoryless model from TR 38.803 Annex A.1. The figure shows the introduced nonlinearity.
if nonLinearityModelOn rapp = comm.MemorylessNonlinearity(Method="Modified Rapp model"); rapp.Smoothness = 1.55; rapp.OutputSaturationLevel = 1; % Plot nonlinear characteristic plotNonLinearCharacteristic(rapp); % Apply nonlinearity for i = 1:size(rxWaveform,2) rxWaveform(:,i) = rapp(rxWaveform(:,i)); release(rapp) end end

The signal was previously repeated twice. Remove the first half of this signal to avoid any transient introduced by the impairment models.
dm = wavegen.ConfiguredModel{4};
if dm == "FDD"
nFrames = 1;
else % TDD
nFrames = 2;
end
rxWaveform(1:nFrames*tmwaveinfo.Info.SamplesPerSubframe*10,:) = [];Measurements
The function, hNRPUSCHEVM, performs these steps to decode and analyze the waveform:
Coarse frequency offset estimation and correction
Integer frequency offset estimation and correction
I/Q imbalance estimation and correction
Synchronization using the demodulation reference signal (DM-RS) over one frame for FDD (two frames for TDD)
Direct current (DC) offset estimation and correction
OFDM demodulation of the received waveform
Fine frequency offset estimation and correction
DC subcarrier exclusion
EVM equalizer spectrum flatness measurement
Channel estimation
Equalization
Common phase error (CPE) estimation and compensation
PUSCH EVM computation according to the EVM measurement requirements specified in Annex F of TS 38.101-1 (FR1) or TS 38.101-2 (FR2) by using the switch
evm3GPP.Power per resource element (RE) calculation for PUSCH, PUSCH DM-RS and PUSCH PT-RS

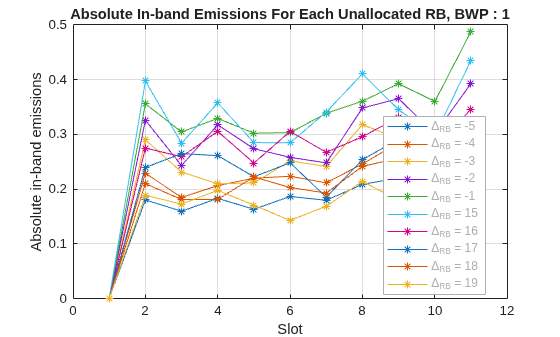

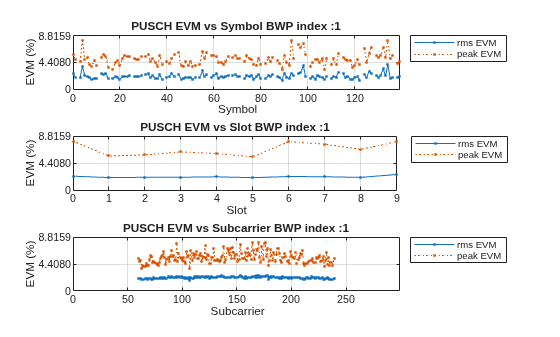

The example measures and outputs various EVM related statistics per symbol, per slot, and per frame peak EVM and RMS EVM. The example displays the EVM for each slot and frame, and displays the overall EVM averaged over the entire input waveform. The example produces these plots: EVM per OFDM symbol, EVM per slot, EVM per subcarrier, overall EVM, and in-band emissions. Each EVM related plot displays both peak and RMS EVM. The example also measures the EVM equalizer spectrum flatness and returns the maximum peak to peak ripples for range 1, range 2 and in between range 1 and range 2.
% Compute and display EVM measurements
cfg = struct();
cfg.Evm3GPP = evm3GPP;
cfg.PlotEVM = plotEVM;
cfg.DisplayEVM = displayEVM;
cfg.IQImbalance = IQImbalanceON;
[evmInfo,eqSym,refSym,specFlat] = hNRPUSCHEVM(wavegen.Config,rxWaveform,cfg);EVM stats for BWP idx : 1 RMS EVM, Peak EVM, slot 0: 2.285 8.014% DM-RS RMS EVM, Peak EVM, slot 0: 1.143 2.898% RMS EVM, Peak EVM, slot 1: 2.060 5.594% DM-RS RMS EVM, Peak EVM, slot 1: 1.584 4.318% RMS EVM, Peak EVM, slot 2: 2.095 5.766% DM-RS RMS EVM, Peak EVM, slot 2: 1.395 3.697% RMS EVM, Peak EVM, slot 3: 2.108 6.269% DM-RS RMS EVM, Peak EVM, slot 3: 1.363 3.200% RMS EVM, Peak EVM, slot 4: 2.180 5.978% DM-RS RMS EVM, Peak EVM, slot 4: 1.837 5.838% RMS EVM, Peak EVM, slot 5: 2.031 5.469% DM-RS RMS EVM, Peak EVM, slot 5: 1.154 2.526% RMS EVM, Peak EVM, slot 6: 2.230 7.946% DM-RS RMS EVM, Peak EVM, slot 6: 1.945 5.022% RMS EVM, Peak EVM, slot 7: 2.194 7.539% DM-RS RMS EVM, Peak EVM, slot 7: 1.627 3.981% RMS EVM, Peak EVM, slot 8: 2.083 6.691% DM-RS RMS EVM, Peak EVM, slot 8: 1.375 2.817% RMS EVM, Peak EVM, slot 9: 2.555 7.942% DM-RS RMS EVM, Peak EVM, slot 9: 1.422 3.515% Averaged RMS EVM frame 0: 2.187% Averaged overall RMS EVM: 2.187%




Peak EVM : 8.0145%
displaySpectralFlatnessMetrics(specFlat)
Slot-wise spectral flatness metrics for bandwidth part ID 1
sf = 10×6 table
slotNumber RP1 RP2 RP12 RP21 Pass
__________ ____________ __________ ____________ ____________ _____
0 {0×1 double} {[0.1875]} {0×1 double} {0×1 double} {[1]}
1 {0×1 double} {[0.1595]} {0×1 double} {0×1 double} {[1]}
2 {0×1 double} {[0.1788]} {0×1 double} {0×1 double} {[1]}
3 {0×1 double} {[0.1533]} {0×1 double} {0×1 double} {[1]}
4 {0×1 double} {[0.1598]} {0×1 double} {0×1 double} {[1]}
5 {0×1 double} {[0.1878]} {0×1 double} {0×1 double} {[1]}
6 {0×1 double} {[0.1799]} {0×1 double} {0×1 double} {[1]}
7 {0×1 double} {[0.1925]} {0×1 double} {0×1 double} {[1]}
8 {0×1 double} {[0.1942]} {0×1 double} {0×1 double} {[1]}
9 {0×1 double} {[0.1934]} {0×1 double} {0×1 double} {[1]}
References
[1] TR 38.803 V14.3.0. "Study on new radio access technology: Radio Frequency (RF) and co-existence aspects." 3rd Generation Partnership Project; Technical Specification Group Radio Access Network.
[2] TS 38.104. "NR; Base Station (BS) radio transmission and reception." 3rd Generation Partnership Project; Technical Specification Group Radio Access Network.
[3] TS 38.101-1. "NR; User Equipment (UE) radio transmission and reception; Part 1: Range 1 Standalone." 3rd Generation Partnership Project; Technical Specification Group Radio Access Network.
[4] TS 38.101-2. "NR; User Equipment (UE) radio transmission and reception; Part 2: Range 2 Standalone." 3rd Generation Partnership Project; Technical Specification Group Radio Access Network.
Local Functions
function plotNonLinearCharacteristic(memoryLessNonlinearity) % Plot the nonlinear characteristic of the power amplifier (PA) impairment % represented by the input parameter memoryLessNonlinearity, which is a % comm.MemorylessNonlinearity Communications Toolbox(TM) System object. % Input samples x = complex((1/sqrt(2))*(-1+2*rand(1000,1)),(1/sqrt(2))*(-1+2*rand(1000,1))); % Nonlinearity yRapp = memoryLessNonlinearity(x); % Release object to feed it a different number of samples release(memoryLessNonlinearity); % Plot characteristic figure; plot(10*log10(abs(x).^2),10*log10(abs(x).^2)); hold on; grid on plot(10*log10(abs(x).^2),10*log10(abs(yRapp).^2),'.'); xlabel('Input Power (dBW)'); ylabel('Output Power (dBW)'); title('Nonlinearity Impairment') legend('Linear characteristic', 'Modified Rapp nonlinearity','Location','Northwest'); end function displaySpectralFlatnessMetrics(specFlat) for idx = 1:size(specFlat,2) % For each BWP slotNumber = specFlat(:,idx).Slot'; RP1 = specFlat(:,idx).RP1'; RP2 = specFlat(:,idx).RP2'; RP12 = specFlat(:,idx).RP12'; RP21 = specFlat(:,idx).RP21'; Pass = specFlat(:,idx).Pass'; fprintf('Slot-wise spectral flatness metrics for bandwidth part ID %d\n',specFlat(:,idx).BandwidthPartID) sf = table(slotNumber,RP1,RP2,RP12,RP21,Pass); display(sf) end end
